You’re running a major capital project, juggling thousands of drawings from separate design teams while every contractor insists their PDF is the latest. Miss one revision and you risk rework, delays, and claims.
Cloud storage alone can’t prevent that chaos. Owners need a system of record that locks each revision, shows only the approved set, and instantly flags any superseded copy that slips onto site.
This guide explains how to control drawing versions on large projects and compares five enterprise platforms built to keep yesterday’s plans out of the field.
Quick answer: seven practical moves every owner needs
Think of drawing control like handing off a baton: the sheet leaves design, clears review, reaches contractors, and finally rests in the archive. Drop the baton once, and the whole job slows.

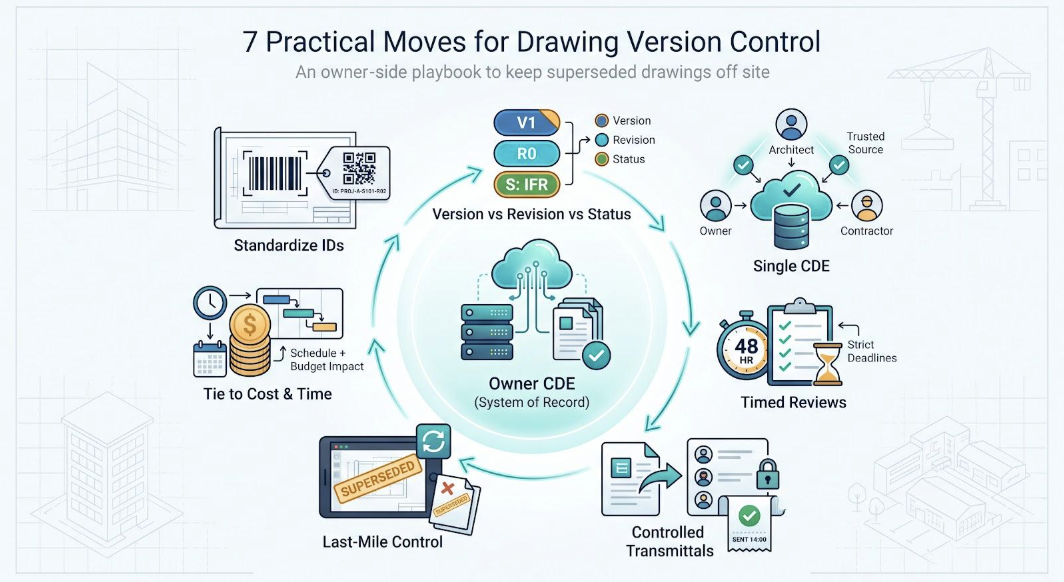

Below is the owner-side playbook designed to attack the root causes of rework. Autodesk and FMI research attributes 52 percent of rework to poor project data and miscommunication.
- Standardize the drawing ID. Create one machine-readable code (discipline, asset, location) that never changes, even if the filename does.
- Separate version, revision, and status. Version = work in progress, revision = formally approved change, status = draft, shared, issued for construction (IFC), superseded, or archived in line with ISO 19650.
- Name a single common data environment (CDE). State in the contract which platform is the source of truth and how others must sync.
- Make reviews timed and traceable. Use serial or parallel workflows with auto-escalation; avoid “looks good” emails.
- Issue through controlled transmittals. Send links that log who received, opened, and acknowledged each revision; attachments stay off-limits.
- Police the last mile. Watermark superseded PDFs, require tablets to sync before shifts, and pull outdated paper sets.
- Tie every revision to money and time. Link each sheet to its RFI, change order, schedule activity, and risk register so finance sees the impact at once.
Follow these moves and most superseded-drawing risk disappears. The rest of this guide shows which platforms automate each step.
How we scored each platform
Before ranking any tool, we built a yardstick owners can reuse. The rubric below focuses on what keeps drawings current across multiple contractors and keeps hidden costs visible.

| Criterion | Weight | Why it matters to owners |
| Revision & supersession control | 20% | Eliminates “Which set is current?” disputes and rework. |
| Cross-organization workflows & transmittals | 15% | Tracks who must review, approve, receive, and acknowledge every sheet. |
| Portfolio-level owner governance | 15% | Lets program offices see status across dozens of projects, not just one job. |
| Linked cost, schedule, and risk data | 15% | Shows the commercial impact the moment a drawing changes. |
| BIM/GIS & file interoperability | 10% | Keeps CAD, BIM, and geospatial files in context throughout design and handover. |
| Mobile & offline field access | 10% | Prevents dead-zone tablets from using superseded PDFs. |
| Security & standards readiness (e.g., ISO 19650 status codes, FedRAMP) | 10% | Satisfies procurement and long-term data custody rules. |
| Pricing-model transparency & TCO clarity | 5% | Exposes hidden collaborator, storage, or archive fees. |
Scores rely on published product docs, current release notes, and live demos. If a feature needs a paid add-on, we grade the base edition you’d likely buy first.
Weightings are flexible. If BIM/GIS poses greater risk on your program, raise that column and see how the rankings move.
Five drawing-control platforms at a glance
Here’s the wall chart owners pin up before vendor demos. Use it to spot the platform that solves your biggest risk first, then confirm the claim in a live demo.
| Tool | Best for | Revision control | Owner governance | BIM / GIS | Offline use | Security / standards note | Pricing model |
| InEight Document | Linking drawings to cost, schedule, risk | Latest revision by default; full audit history | Portfolio dashboards; concurrent projects | IFC, RVT via integrations | Syncs docs and markups in no-signal zones | ISO-style status codes; FedRAMP Moderate Equivalency Authorized | Quote; module + user |
| Oracle Aconex | Formal multi-party project record | Immutable register, tracked transmittals | Strict workflows, JV & supplier matrices | IFC + BCF coordination | Mobile app with selective sync | FedRAMP Moderate (defense edition) | Quote; project-value + user |
| Kahua | Configurable public-owner programs | Controlled folders auto-supersede | Network sharing, granular permissions | Built-in BIM viewer; GIS connectors | Offline markup with conflict resolution | FedRAMP, GovRAMP, ISO 27001 | Quote; construction-value tiers |
| Bentley ProjectWise | Engineering & GIS-heavy infrastructure | Reference-file aware; AI change flags | Asset context; map-based portfolio | Deep CAD, 50+ formats, spatial views | Web & mobile offline cache | FedRAMP Moderate; ISO 19650 workflows | Published seat & bundle prices |
| Procore | Field adoption & contractor ease | Auto-naming, overlay, watermarked old sets | Owner views; contractor friendly | Model Manager (UK general availability; US beta) | Strong offline on iOS & Android | ISO 27001; FedRAMP Moderate Authorized (Procore for Government) | Annual construction-volume fee |
No single row wins every column. Match the strongest column to your highest-stakes pain point, then ask the vendor to prove it in the demo.
Tool #1: InEight Document – best overall for connected owner control
Why it tops the list
InEight Document’s register always shows the latest approved revision and locks every earlier version in an immutable audit trail. The platform’s guide to construction document control notes that this rigor can slash document search time by up to 75 percent and cut email attachments by 90 percent, preventing the classic nightmare of pouring concrete from a superseded detail.
InEight Document drawing register and revision history interface screenshot
Each upload receives a new revision number with user, time, and status stamps. Owners can rewind any sheet’s history in seconds, ending “who had what when” disputes.
The module connects with InEight’s Estimate, Schedule, Control, Contract, and Risk apps, so a drawing change can instantly update quantities and forecasts. You get one line of sight from sheet to budget to activity bar.
Field crews benefit too. The mobile app syncs the current set before a shift, lets teams mark up drawings offline, then reconciles changes once a signal returns. Transmittals log who downloaded each revision and alert document control if an old copy is still in use.
Validation points to check in a demo
- Confirm how its FedRAMP Moderate Equivalency Authorized status applies to your agency requirements.
- Ask to see GIS links if your assets live on a map rather than a floor plan.
- Request pricing for Document alone and for the integrated suite.
That blend of revision discipline plus cost-and-schedule context is why InEight earns the top spot for owner-led capital programs.
Tool #2: Oracle Aconex – best for formal cross-company records
Where it shines
- Immutable register. The moment a file is uploaded, Aconex adds a new line that no one can overwrite or delete. Years later, claims teams can trace the exact revision that was in force.
- Receipt-aware transmittals. Issue a drawing and the dashboard shows who received it, who opened it, and who still has not acknowledged, which matters when a safety hold depends on that click.
- Permanent project mail. Messages and attachments link directly to the document register, closing the classic “I never saw that detail” defense.
Governance across separate firms
Joint ventures and supplier networks keep their own IT policies, yet Aconex lets them share one structured register. Review matrices spell out who approves what and when, and overdue steps escalate automatically without ad-hoc reminder emails.
What owners should validate
- Offline field use. Offline sync differs by license tier; match it to your site conditions.
- Linked controls. Cost and schedule integration lives in separate Oracle modules, so add them if you need one click from drawing to change order.
- Pricing logic. Fees follow project value and named users, which means late-stage consultant adds can raise the bill.
- Security scope. Aconex for Defense holds FedRAMP Moderate and DISA IL4 authorization; confirm if that level is required for your program.
If a court-ready record that every participant must respect is your top priority, Aconex remains the benchmark.
Oracle Aconex immutable document register and transmittals dashboard screenshot
Tool #3: Kahua – best for configurable public-owner programs
Built for agencies, not just projects
Transportation authorities, school districts, and utilities rarely run a single mega job at a time. Kahua assumes you’re juggling dozens. Its controlled folder workflow auto-flags any earlier revision as superseded the instant a new PDF lands in the Drawings app. Contractors see the update the next time they sync—no macros, no manual moves.
Because every form and workflow is configurable, one bridge can follow a four-step review while a pump station follows six, yet both feed the same executive dashboard.
Security that satisfies procurement
Kahua holds FedRAMP Moderate authorization, GovRAMP validation, ISO 27001 certification, and SOC 2 Type II reports—credentials that keep federal and state auditors happy for the 25-year custody many public owners require.
Practical watch-outs
- The dedicated Drawings app arrived in the May 2026 (Q2) release; confirm its sheet-splitting and title-block extraction match your volume.
- RVT and IFC viewing is new; test how it exchanges data with your GIS or asset system.
- Pricing ties to annual construction value, so model a high-spend year before signing.
If you need governance you can adjust without months of change requests and a security posture built for public funding, Kahua should make your demo shortlist.
Tool #4: Bentley ProjectWise – best for engineering and GIS-rich infrastructure
Built for live design data
Most CDEs focus on finished PDFs; ProjectWise manages the messy work-in-progress stage of CAD. It tracks every reference file and X-ref, so you always know which culvert base file feeds a highway corridor and who still has it checked out. Swap a base file and ProjectWise ripples the change through dependent drawings, flagging teams that must re-publish.
Spatial context baked in
Infrastructure owners think in miles and chainages, not floorplates. ProjectWise overlays models on a map, letting you click from a bridge pier to the sheet that details its rebar cage. Utilities can drill down from a GIS asset to every revision of a substation layout, an early step toward the draft ISO 23143-1 BIM-GIS exchange standard.
Digital twin integration
ProjectWise connects directly to Bentley’s iTwin Platform, allowing teams to view, share, and analyze 3D models and drawings in a web browser without specialized CAD software. Stakeholders review the live model rather than static PDFs.
Points to double-check
- Cost and risk linkage. ProjectWise centers on design governance; budget impact lives in other Bentley or third-party tools.
- User learning curve. Engineers value the depth; occasional users need training.
- Scaling costs. Entry prices start at $960 per seat per year, but enterprise bundles rise quickly【bentley pricing page】.
- Security tier. ProjectWise gained FedRAMP Moderate authorization in April 2026; confirm if that meets your program’s threshold.
For owners whose projects rely on complex CAD relationships, and whose assets must sit accurately on a map, ProjectWise offers precision no generic file store can match.
Tool #5: Procore – best for field adoption and contractor speed
A job-site workhorse
Walk into almost any trailer and someone is scrolling Procore drawings on an iPad. The familiar interface, one-tap sync, and color-coded compare tool suit foremen who need to mark steel before the concrete truck arrives.
Procore auto-numbers each sheet, stacks new revisions over the old, and tags superseded drawings with a red banner so crews don’t print stale details. Offline mode caches files for basement work zones and reconciles notes once Wi-Fi is back (a workflow spelled out in Procore’s mobile guide【Procore Mobile Sync doc, Dec 23 2025】).
Owner perspective
Owners get two wins: unlimited user licenses that make it inexpensive to invite every subcontractor, and tight links between drawings, RFIs, punch items, and inspections. For dozens of small projects, cost per job can beat per-seat tools.
Areas to probe:
- ISO 19650 support. Full CDE status codes are generally available in the UK and Ireland but remain beta elsewhere【Procore ISO FAQ, Oct 12 2026】.
- Security tier. Procore holds ISO 27001 certification and lists a FedRAMP Moderate Authorized (Procore for Government) offering; confirm schedule if your contract requires Moderate authorization.
- Pricing swings. Fees follow annual construction volume, not user count. Model a super-cycle year before signing.
If success depends on contractors opening the right drawing today, and not on curating a 30-year archive, Procore delivers adoption and speed that few rivals match.
Where each platform wins
Think of it like sorting bids: match your biggest risk to the tool that solves it first.
| Scenario | Best pick | Why this tool edges ahead |
| Drawing change linked instantly to cost, schedule, risk | InEight Document | Native connections to estimate, change, and risk modules keep budget exposure visible the moment a sheet moves. |
| Court-ready, multi-party audit record | Oracle Aconex | An immutable register and mail log accepted on government programs provide end-to-end evidence. |
| Public agency needing strict security and configurable workflows | Kahua | FedRAMP Moderate authorization and click-to-edit forms let owners enforce project-specific governance without code. |
| Complex CAD dependencies and GIS context | Bentley ProjectWise | Tracks every reference file and pins drawings to GIS assets; connects directly to iTwin Platform for web-based 3D model review. |
| Fast contractor adoption and offline field use | Procore | Unlimited users and proven offline mobile apps keep crews on the current set even in dead zones. |
Owner system of record versus contractor field platform
Most capital programs run two systems in parallel. The owner needs a long-life CDE that locks approvals and preserves the record long after contractors demobilize. Contractors want a field-friendly tool that lets foremen red-line steel details on the fly.
Running both is a risk-management strategy, not redundancy. The contract should name one platform, the owner CDE, as the authoritative source. Every revision, status change, and transmittal must start there or be mirrored within minutes. If a contractor uploads a sheet in Procore at 3 pm, the match should appear in the owner register by 3:05 pm with metadata and audit stamps intact.
API exchanges beat manual uploads because they remove re-keying and preserve the who, what, and when auditors need. When APIs are not available, disciplined transmittals and import templates take over: hourly sync for active packages, daily for archived sets.
Data ownership matters just as much. Dodge’s 2025 “data-centric owner” report found that only 23 percent of owners use data-centric approaches at scale, a gap driven largely by fear of losing control. A clear system-of-record clause and export schedule removes that fear: contractors keep the tool they like, and owners keep the archive complete.
At hand-over, the contractor platform should export native files, PDFs, metadata, approval logs, and correspondence. The owner CDE then feeds GIS, asset-management, and digital-twin systems for the next 30 years.
Treat the dual-platform model as deliberate architecture: contractor speed on site, owner certainty in the boardroom.

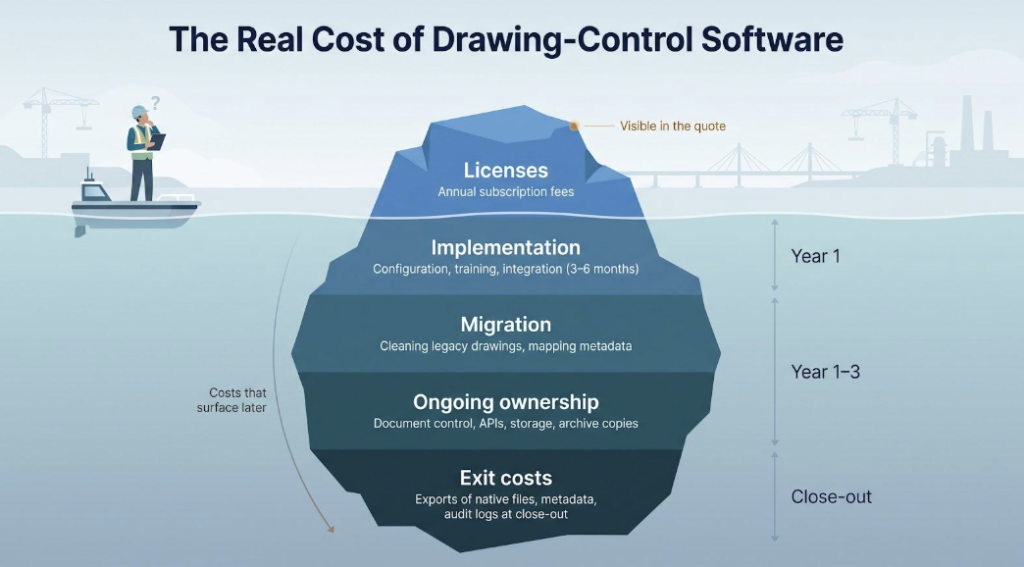

What drawing-control software really costs
Subscription fees are just the starting line; the larger numbers lurk in setup, migration, and custody.
- License logic
- InEight and Aconex price by module or named user.
- Bentley posts per-seat rates, but bundles escalate quickly.
- Procore and some Kahua tiers peg fees to annual construction volume, so cost swings with capital spend.
- Implementation
Designing metadata schemas, approval flows, and security roles is a major task. For a mid- to large-organization adopting an enterprise platform, implementation typically takes 3 to 6 months to complete data migration, integration, and user training. Plan workshops for each major contractor plus sandbox testing so no one learns on live data.
- Migration
Legacy drawings often lack revision blocks and contain duplicates. Cleaning and mapping can double the first-year bill; insist on a fixed-price data-prep line, not variable day rates.
- Ongoing ownership
Document controllers, API maintenance, storage overages, and archive copies add up. Without dedicated document control, construction professionals lose an average of 5.5 hours per week searching for project information, representing a large hidden labor cost.
- Exit costs
Exporting native files, metadata, and audit logs at close-out can trigger per-gigabyte fees. Put a hard number on that clause before signing, or the lowest annual rate becomes the priciest endgame.
Run low, medium, and peak-spend scenarios before you compare vendors; only then will the real price picture come into focus.
Standards and future-proofing
Vendor logos change, but information standards can last 30 years. Choose software that flexes with new rules, or plan on exporting to spreadsheets later.
ISO 19650 (draft 2nd edition, 2026). Broadens the focus from “BIM files” to lifecycle information and defines the CDE as an operational framework, not just a folder. Staying close to that language future-proofs both workflows and contracts.
ISO 19650-6: 2025. Adds structured health-and-safety data. Ask vendors to show where those H&S attributes live in the metadata, never buried in PDFs.
ISO/DIS 23143-1 (BIM-GIS exchange). Moves BIM data into geospatial context. If your asset strategy leans on GIS, confirm the platform can already tag drawings to spatial IDs and expose them through open APIs.
BuildingSMART IDS 1.0 (2024). Provides machine-readable information requirements so you can validate metadata automatically. A platform that supports IDS today will adapt faster to future ISO updates.
AI assistants such as title-block extraction, change detection, and semantic search only work on disciplined data. Consistent revision codes and ISO-style status fields form the backbone. Invest in standards early and later automation comes cheaper, faster, and with fewer caveats.

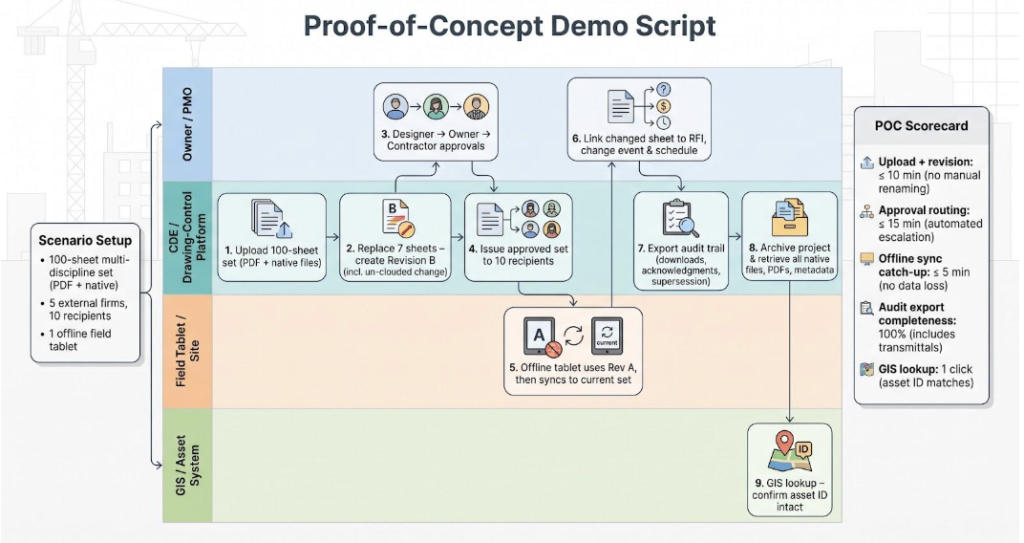

Proof-of-concept demo script
A flashy demo can charm, but a controlled test secures budget. Give every vendor the same mini-project and compare how each platform handles real pressure.
Scenario setup
- 100-sheet, multi-discipline drawing set (PDF + native files)
- Five external firms; ten named recipients
- One offline field tablet
Step test
- Upload the full set.
- Replace seven sheets (one with an un-clouded change) to create revision B.
- Route for designer → owner → contractor approval.
- Issue the approved set to all ten recipients.
- Open revision A on the offline tablet; reconnect and sync.
- Link one changed sheet to an RFI, change event, and schedule activity.
- Export the audit trail (downloads, acknowledgments, supersession notices).
- Archive the project and retrieve every native file, PDF, and metadata record.
- Locate the drawing from the GIS map and confirm the asset ID is intact.
Scorecard
| Metric | Target | Notes |
| Upload + revision time | ≤ 10 min | No manual renaming |
| Approval routing | ≤ 15 min | Automated escalation |
| Offline sync catch-up | ≤ 5 min | No data loss |
| Audit export completeness | 100% | Includes transmittals |
| GIS lookup | 1 click | Asset ID matches |
Any platform that completes the script inside 60 minutes without spreadsheets moves to the negotiation table.
Common mistakes to avoid
Owners rarely fail because they bought the wrong software; they fail when familiar habits slip through the cracks.
- Treating cloud storage as document control. A shared drive records versions, not revisions. Without status codes and approvals, every file is “maybe current.”
- Using email attachments instead of transmittals. Attachments bypass the audit trail, so when a claim lands, the inbox is empty, and so is your evidence.
- Forgetting cached or printed copies. Offline tablets and Friday-afternoon print sets can linger for weeks. Unless the platform forces a sync or watermarks old sheets, those copies remain in circulation.
- Re-issuing full packages for every change. On complex jobs, single sheets update faster than whole sets. If the register can’t revise one drawing without re-issuing fifty, field teams will bypass the process.
- Migrating dirty data. Ten years of cryptic filenames poison search, automation, and AI change detection. Clean first, migrate second.
- Buying on list price alone. Implementation, data prep, and export fees can eclipse subscription costs by year three. Price the lifecycle, not the license.
Frequently asked questions
What’s the difference between a version and a revision?
A version is a saved work-in-progress state. A revision is a formally approved change that supersedes the last issued sheet.
Can SharePoint handle drawing revision control?
Technically yes, if you add naming scripts, Power Automate approval flows, transmittal logs, and a PDF viewer or markup plug-in. Microsoft’s own guidance notes that this equals a small development project【Microsoft Docs “Plan document management,” 2026】. Purpose-built CDEs often prove faster and cheaper at scale.
How do we stop contractors from using superseded drawings?
Require a sync at the start of each shift, watermark or block outdated PDFs, and notify anyone who downloaded the prior revision. Platforms such as InEight Document and Procore Mobile automate these steps.
Does ISO 19650 force you to buy specific software?
No. The standard defines information states and approval gates, not brands. Your platform simply has to support status codes, suitability fields, and an auditable workflow.
What fields should a drawing register track at minimum?
Unique ID, title, discipline, current revision, status, suitability, originator, checker, approver, issue date, superseded date, distribution list, and links to RFIs or change events.
Can AI really detect un-clouded changes?
Yes. AI drawing review platforms like Buildcheck use computer vision to compare geometry and text to flag silent edits. Remember: AI suggests; humans approve.
Who owns the data after handover?
Whatever the contract states. Secure continuous owner access, open-format exports, and a no-fee archive clause before the first drawing hits the register.
How much should we budget for implementation?
Implementation costs vary, but for mid- to large organizations adopting enterprise platforms, configuration, data migration, and training typically take 3 to 6 months. Factor this time and resource commitment into total cost, not just license price.
Conclusion: choose quickly, test hard, and document forever
Drawing control isn’t glamorous, yet it underpins every concrete pour, cable pull, and inspection on a major program. Each of the five platforms covered can stop superseded sheets from reaching the field, but each excels in a different lane:
- InEight connects drawings to cost and schedule.
- Aconex locks a legally defensible record.
- Kahua lets public owners configure governance without code.
- ProjectWise guards the engineering and GIS core of infrastructure.
- Procore drives fast field adoption.
Short-list the two that match your biggest risk, then run the proof-of-concept scorecard. Time how long each vendor takes to move a drawing from upload to “issued,” flag a rogue offline copy, and export the audit trail at close-out.
Do that and you’ll know, in real time and in black and white, which platform keeps the night shift on the right revision. Download the demo script, pick your front-runner, and make them prove it.
