You are here: Home / *BLOG / Around the Web / HDD Locating in U.S. Fiber Builds: How Contractors Can Cut Downtime, Utility Strikes, and Equipment Waste

HDD Locating in U.S. Fiber Builds: How Contractors Can Cut Downtime, Utility Strikes, and Equipment Waste

June 9, 2026 By GISuser

U.S. fiber construction no longer rewards crews that treat locating as a single tool choice. The hard work has moved into congested streets, weak-record corridors, rural routes with thin locate capacity, rocky ground, and crossings where a wrong depth reading can stop the job. Contractors need a locating stack, a risk-based workflow, and procurement rules that protect uptime.

Why U.S. Fiber Builds Are Changing HDD Work

Broadband funding has increased the volume and urgency of underground work. The BEAD program carries $42.45 billion for broadband deployment, mapping, training, and workforce readiness. The FCC also raised the fixed broadband benchmark to 100/20 Mbps. These two forces push builders toward fiber-heavy networks and deeper construction in routes that earlier programs often avoided.

The economic signal is clear. The FBA and Cartesian 2025 deployment cost study reported typical underground deployment at $18.00 per foot, compared with $8.00 per foot for aerial work. Labor accounted for 72% of underground cost. Rocky terrain reached a median underground cost of $22.00 per foot. When a crew waits on a late markout, re-drills after a bad depth reading, or stops for an emergency pothole, the project loses money in its largest cost bucket: labor.

This does not mean every broadband mile should use HDD. It means project teams should use HDD where it protects the route: under pavement, railroad tracks, waterways, landscaped areas, congested utility corridors, and other segments where trenching creates higher restoration, safety, or permit risk.

The Main Failure Mode: Locating Risk Controls Uptime

Interference and depth distortion

Walk-over locating works well on many fiber bores, but interference can corrupt both location and depth. OEM guidance from Subsite and DCI warns that crews should not trust readings that appear slowly, fluctuate, or fail stability checks. That warning matters because fiber bores often run near power, communications, gas, sewer, water, traffic loops, reinforced concrete, rebar, culverts, guard rails, and chain-link fencing.

Active interference comes from energized infrastructure and radiated electromagnetic fields. Passive interference comes from conductive objects that distort the signal path. Frequency choice can help, but it cannot turn a bad reading into a safe reading. A crew must treat unstable data as a stop-work signal, not as a minor inconvenience.

Utility congestion and weak records

Many remaining fiber corridors combine high utility density with poor records. Rural routes may lack complete maps. Older urban and suburban routes may include private utilities, abandoned assets, and undocumented laterals. Recent locating-practice reports show that high-volume fiber programs can overload 811 and locator capacity. In one GFiber case study, revised coordination with 811 centers, locators, and subcontractors cut locate-related delays by 39% across projects in 10 states.

The lesson is simple: locate management is a production workflow. It needs schedule logic, ownership, quality checks, and escalation rules. Contractors should not assume that a ticket, a map, or an old markout proves the bore path is safe.

Soil and ground conditions

Ground conditions affect drilling and locating at the same time. Rock slows production and increases tool demand. Wet, clayey, or saline soils can reduce GPR performance because they attenuate electromagnetic waves. Mixed terrain can force crews to change method, drill class, tooling, and verification steps inside the same build area. These changes must appear in the bore plan before the rig reaches the site.

A Modern Fiber HDD Crew Needs a Locating Stack

A single locator cannot cover every fiber job. Walk-over sonde guidance still carries routine bores. EM utility locators trace conductive assets before excavation. RTK/GPS mapping turns field data into usable as-builts. GPR fills blind spots where records are weak or assets are non-metallic. Gyro and inertial steering take over when magnetic interference, depth, or crossing risk makes walk-over locating unreliable.

Two distinctions protect crews from bad decisions. First, GPS/RTK is not a locating method by itself. It georeferences field points, but another tool must sense the asset or guide the drill head. Second, GPR is not a steering method. It can reveal undocumented utilities and voids, but it does not replace sonde or gyro guidance during the bore.

Buy Equipment for Uptime, Not for the Lowest Sticker Price

Fiber contractors should match equipment to utilization, ground risk, and support needs. Compact drills still fit most neighborhood fiber work because they move well in tight streets and small residential corridors. Larger or all-terrain units make sense when bore length, rock, pullback, or production pressure justifies the higher capital cost. Digital displays and backup guidance components matter because they reduce troubleshooting time and help less-experienced operators make consistent decisions.

The strongest procurement rule is this: own the assets the crew uses every week, and rent or outsource the tools needed only when risk spikes. A typical fiber-era package includes a compact production drill, a standardized walk-over guidance family, backup display and power components, utility EM locating, potholing support, and access to GPR or gyro services for corridors that exceed normal walk-over risk.

Service support belongs inside the equipment decision. Dealers, loaners, parts availability, calibration help, rental bridges, and training can decide whether the rig keeps working when a display fails, a beacon dies, or a project suddenly needs a different locating layer.

U.S. Case Studies Point to the Same Operational Pattern

Recent field examples do not point to one magic tool. They point to better coordination, better records, earlier potholing, stronger route classification, and cleaner handoffs between office planning and field execution.

GFiber’s delay reduction shows the value of coordinating the locate workflow as a production system. Harnett County shows why weak rural records justify better SUE and private locating. Missouri fiber projects show why mixed-method construction, GPS-based field documentation, and potholing discipline can matter as much as rig horsepower. Public middle-mile plans in California show why agencies reserve HDD for difficult crossings and constrained segments.

A Field Workflow That Reduces Utility Strikes and Idle Time

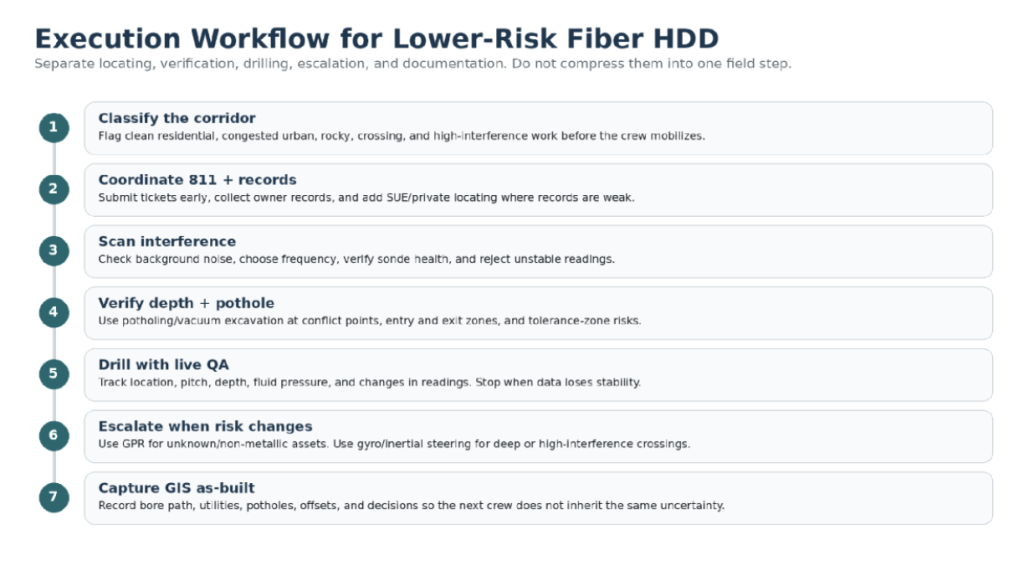

A safe and productive fiber bore starts before the first rod. The crew should know the corridor risk, utility record quality, expected interference, ground type, depth targets, conflict points, potholing plan, and escalation trigger. This workflow separates those decisions so crews do not compress them into a rushed field judgment.

The stop-work rule should be explicit. If the receiver data becomes unstable, the depth reading does not match the planned geometry, a markout conflicts with field evidence, or the bore enters a higher-risk segment than planned, the crew pauses and escalates. Escalation may mean another frequency, a second locator, potholing, GPR, SUE review, gyro guidance, or a route change.

Classify Bore Risk Before Assigning Tools

Project teams often write broad requirements such as “locate utilities” or “verify depth.” That language is too weak for high-volume fiber work. A better plan assigns a locating package by corridor type and consequence. Clean residential bores should not carry the same process as a railroad crossing or an urban route with poor records and non-metallic assets.

This classification also helps procurement. A contractor can buy the standard tools needed for low- and medium-risk work, then maintain rental or specialist access for the high-risk layer. That approach keeps capital tied to utilization instead of rare edge cases.

Stakeholder Handoffs Can Create the Delay

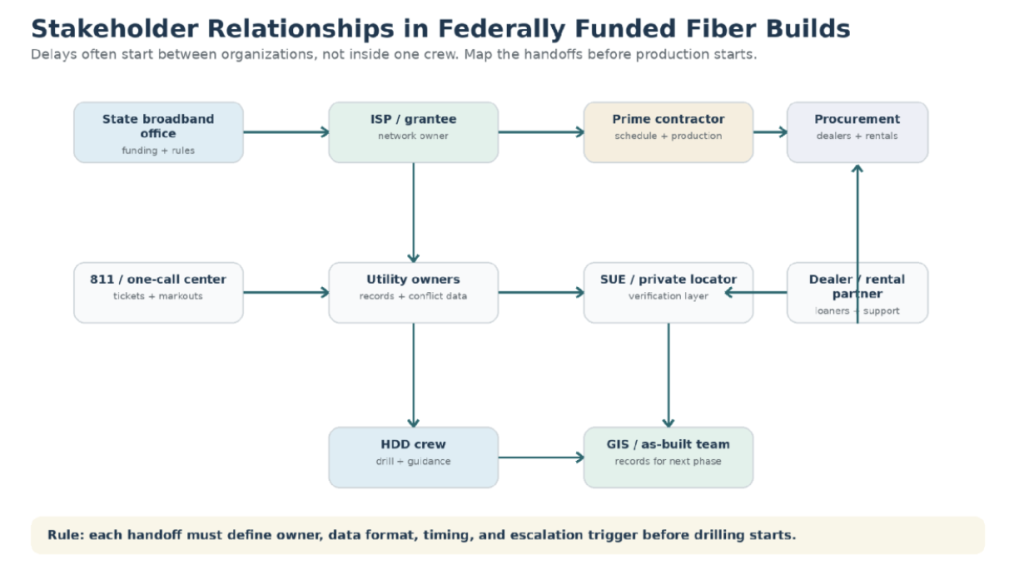

Fiber HDD does not fail only in the bore pit. Delays often start when the state office, ISP, prime contractor, utility owner, 811 center, private locator, dealer, and field crew do not share the same schedule or data. Each handoff needs an owner, a format, a deadline, and an escalation rule.

The GIS and as-built layer deserves special attention. When one crew records potholes, unknown utilities, bore path decisions, and offset data, the next crew starts with fewer unknowns. This turns today’s locate work into tomorrow’s risk reduction.

Action Plan for Contractors, Engineers, and Procurement Teams

For contractors

  • Standardize the pre-bore interference scan and frequency-selection process.
  • Verify depth daily and after any change in readings, soil, route, or transmitter behavior.
  • Use potholing or vacuum excavation at conflict points, tolerance zones, and entry/exit areas.
  • Define stop-work triggers for unstable readings, unclear marks, missing records, and high-consequence crossings.
  • Train operators on locating discipline, not only drill controls.

For engineers and project managers

  • Classify each bore by corridor risk before procurement and mobilization.
  • Specify which locating layer applies to each risk class: walk-over, EM, RTK/GPS mapping, GPR, or gyro.
  • Separate utility locating, verification, potholing, and drilling tasks in the schedule.
  • Require GIS-ready as-builts and field notes so later phases do not repeat the same uncertainty.
  • Track delays by cause: late locate, record conflict, interference, potholing, repair, permitting, or equipment downtime.

For procurement teams

  • Buy the core production stack used every week: compact drill, walk-over locator family, remote display, batteries, beacons, and basic utility locating tools.
  • Rent or outsource specialty layers: extra locators, GPR, vacuum excavation support, and gyro or inertial steering.
  • Compare dealers by uptime support, not only purchase price. Ask about loaners, calibration, parts, service response, and rental bridges.
  • Keep backup displays, batteries, chargers, and transmitters in the standard package when the crew works on tight production schedules.
  • Tie training to 811, SUE, potholing, GIS, and interference-response workflows.

For HDD equipment sourcing

Contractors that standardize on proven walk-over guidance can compare Underground Magnetics locating equipment as part of a practical uptime package: receiver, transmitter, remote display, spare power, support parts, and rental coverage for surge demand. The link should support the procurement decision; it should not replace the risk classification and field workflow above.

Common Mistakes That Increase HDD Fiber Risk

Mistake 1: Treating a clear ticket as a clear bore path

A clear ticket does not prove that the corridor contains no conflict. It proves the ticket process returned a status. Crews still need field verification, visual evidence, depth checks, and potholing where the consequence of error is high.

Mistake 2: Using GPS as if it locates utilities

GPS records the position of a point. It does not detect a buried utility or steer a drill head. Pair RTK/GPS with EM locating, GPR, potholing, and as-built documentation.

Mistake 3: Forcing walk-over locating through bad interference

Multi-frequency locators help crews adapt, but they do not make unstable readings safe. If interference distorts the signal, crews should pause, verify, and escalate.

Mistake 4: Buying the rig but not the uptime package

A rig without backup guidance components, dealer support, calibration discipline, and trained operators can still lose days to small failures. Uptime comes from the package, not the machine alone.

Mistake 5: Leaving field notes outside the project record

A pothole location, an abandoned line, a changed bore path, or an interference zone has value only if the team captures it in a format the owner, GIS team, and next contractor can use.

What Comes Next for U.S. Fiber HDD

The next phase of U.S. broadband work will likely become more demanding per mile. The easiest aerial routes and clean underground corridors are often already used or planned. Remaining work will lean toward crossings, urban infill, mixed utility corridors, rocky rights-of-way, rural routes with weak records, and streets where restoration or permitting risk favors trenchless methods.

This will not reward contractors that simply add larger drills. It will reward contractors that reduce avoidable stoppages. The strongest crews will know when walk-over locating is enough, when GPR or potholing must enter before drilling, when gyro steering protects a crossing, and when the bore plan must change.

Source Priorities and Limits

The research behind this article relies most heavily on primary policy sources, safety and damage-prevention data, industry cost studies, OEM technical guidance, and public field case studies. Pricing remains less complete because many HDD locators, guidance systems, and current rig models sell through dealer quotes rather than universal MSRP pages. Contractor and manufacturer case studies provide useful field evidence, but they should guide decisions rather than act as controlled benchmarks.

Conclusion

Fiber HDD work in the U.S. is shifting from simple production boring to risk-controlled underground construction. Funding scale, higher broadband expectations, labor-heavy cost structure, and harder corridors make locate quality a business issue. Contractors can protect margin by building a layered locating stack, classifying bore risk, adding potholing and escalation rules, capturing GIS-ready records, and buying equipment as an uptime system.

The winning package is practical: right-sized rigs, reliable walk-over guidance, utility tracing, RTK/GPS documentation, backup components, access to GPR and gyro support, rental options, and training tied to 811/SUE/GIS workflows. That package helps crews keep drilling only when the data is good enough to drill.

Filed Under: Around the Web

Editor’s Picks

Learn to Make Decisions Using Lidar Data and Geographic Information Systems

USGS Lidar Base Specification Version 1.2

Social Media is an Increasingly Important Part of Webmaps, Data Analysis, Analytics and Visualizations

Esri Indonesia Story Map Explores Missing AirAsia Flight 8501

See More Editor's Picks...

Recent Industry News

Top Benefits of AI Video Surveillance for Businesses and Public Spaces

June 5, 2026 By GISuser

How to Choose the Best Office Interior Designers in Delhi for End-to-End Projects

June 3, 2026 By GISuser

Why Bathroom Renovation Services Often Change More Than Just the Bathroom

May 20, 2026 By GISuser

The Drift Between Early Notes and Final Case Files in Abuse-Related Legal Support

April 29, 2026 By GISuser

Hot News

State of Data Science Report – AI and Open Source at Work

HERE and AWS Collaborate on New HERE AI Mapping Solutions

Virtual Surveyor Adds Productivity Tools to Mid-Level Smart Drone Surveying Software Plan

Categories

Copyright gletham Communications 2015 - 2026

Go to mobile version
